Costs and Financing

Project Finance

Western Power will employ a Project Finance structure to raise the money required to construct the project.

Project Finance is commonly used to finance large infrastructure projects as it uses the security of a long-term contract – in this case a contract to sell electricity for 25 years – as security to borrow up to 80% of the project cost from a group of lenders.

Lenders are likely to be Development Finance Institutions, which are organisations funded by governments and mandated to support infrastructure projects in the developing world.

Western Power is discussing the terms of a Power Purchase Agreement (PPA) with ZESCO, the Zambian national utility, for the purchase of all the electricity produced by the power station for 25 years.

$ 0 m

Total project cost more than $650m

$ 0 m

Development spend to date is approximately $13m

$ 0 m

Development spend remaining approximately $6m

0 years

Construction funded using a Project Finance structure with up to 75% raised as debt from Development Finance Institutions secured against a long-term offtake agreement (25-year PPA with ZESCO).

Financial close targeted
Q4-2024.

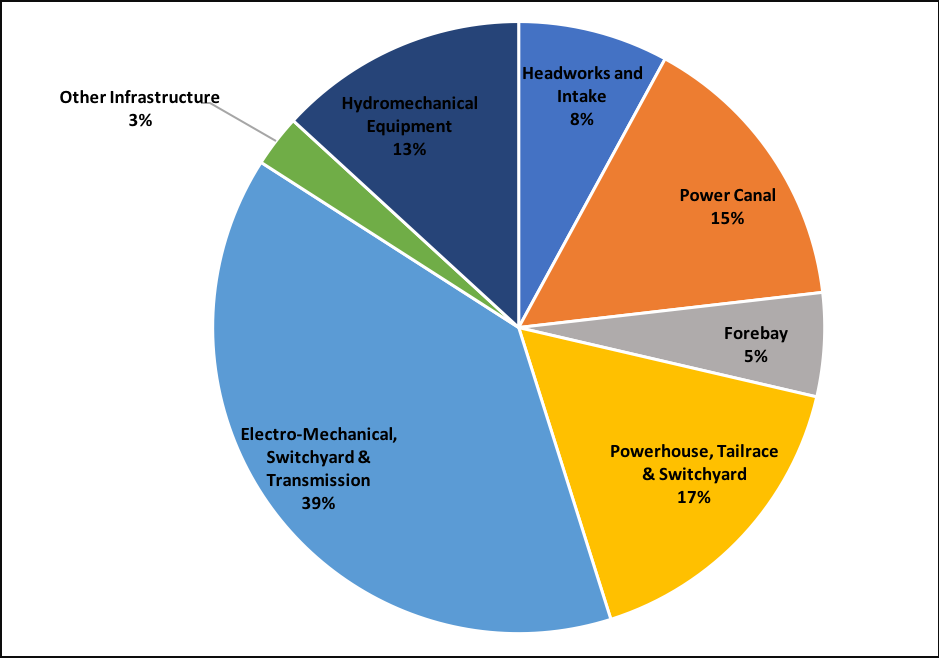

Construction Costs Breakdown

The construction costs breakdown as follows:

  • 39% = Electro-Mechanical Switchyard & Transmission
  • 17% = Powerhouse, Tailrace & Switchyard
  • 15% = Power Canal
  • 13% = Hydromechanical Equipment
  • 8% = Headworks and Intake
  • 5% = Forebay
  • 3% = Other Infrastructure
